Serving Fullerton, CA and surrounding areas.(657) 500-3759
Harbor Fullerton Concrete

Stamped Concrete Services in Fullerton, CA, a Finish With No Second Pass

Harbor Fullerton Concrete chalks the pattern off a datum before the forms go down, because a mat cannot be shifted once it has taken. Color, grout lines and the sealer date all go on the sheet.

Google reviewsFacebook reviewsBetter Business Bureau reviews5.0 Stars How customers score us · Google, Facebook and the BBB

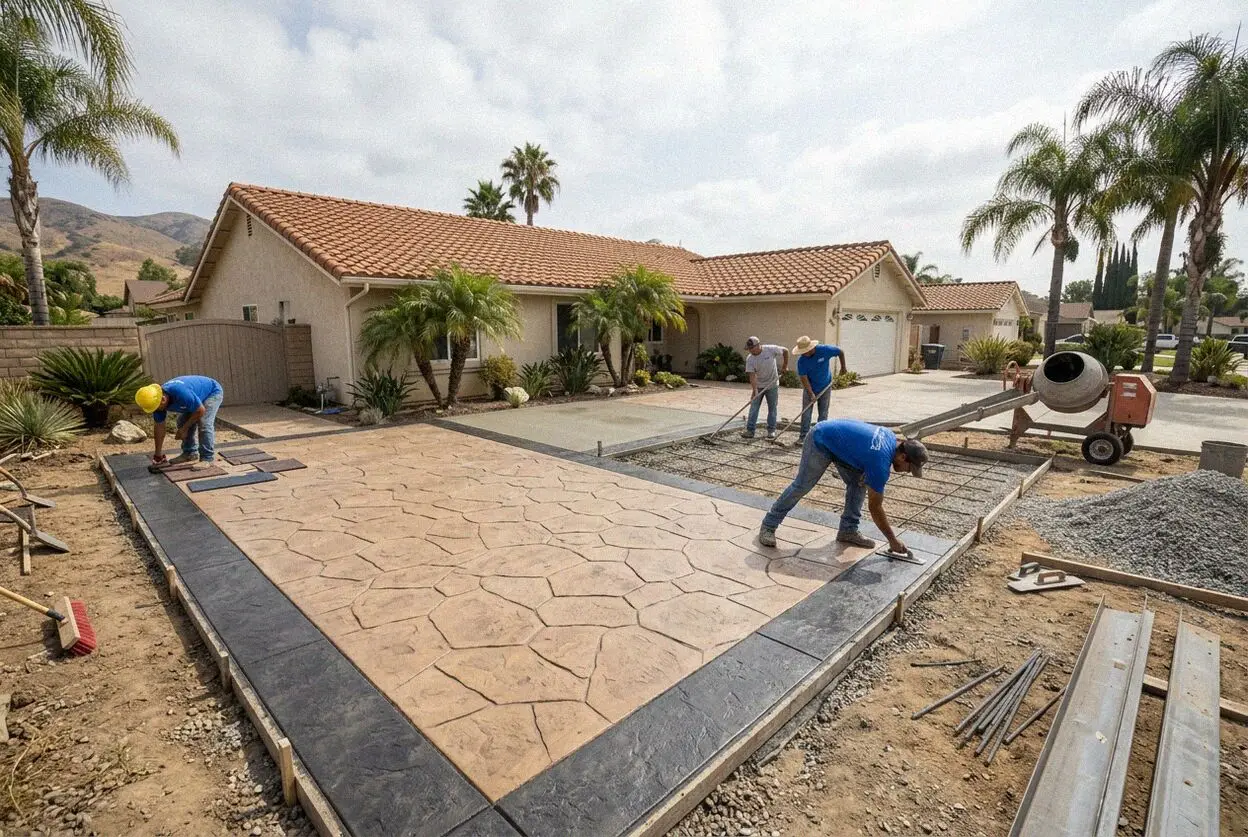

Crew pressing a stamp mat into a fresh slab at a Fullerton home

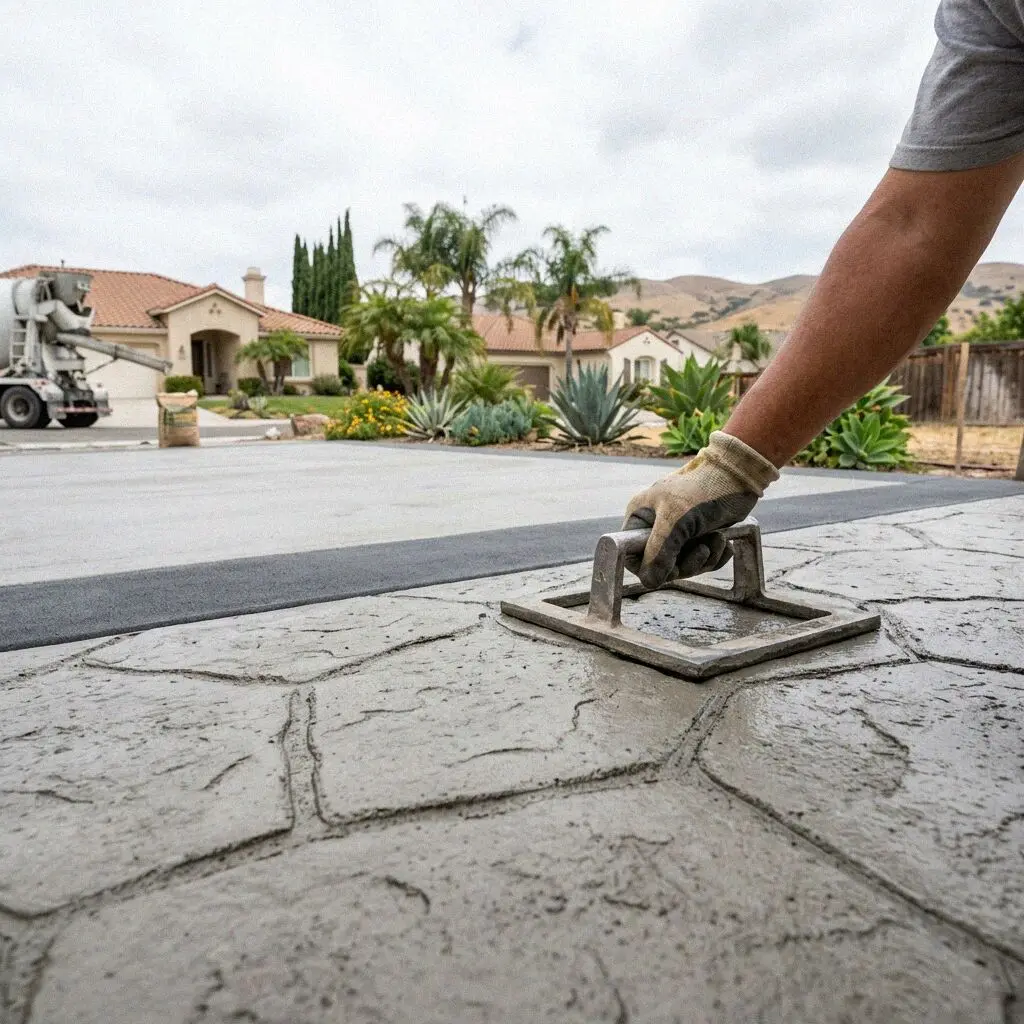

Stamp mats laid out dry over the forms of a Fullerton slab

A finish, not a kind of slab

What Stamping Adds to a Slab in Fullerton

Stamping is a finish rather than a kind of concrete. What sits underneath is the same 4 inches on the same compacted rock a broom-finished pour gets, and everything that makes the slab stamped work happens in the top half inch: pigment batched through the load or cast onto the surface as a dry hardener, a release powder so the mats lift clean, and the pattern pressed while the top is still soft. None of that is a coating rolled on later, and none of it can be moved once it has taken.

Fourteen years on crews across north Orange County came before the yard, which Grant Yoshida opened in 2021, and he strikes the datum himself on the morning of a pour. A mat leaves an impression a quarter of an inch deep and it stays where it lands, so the first line is set off the house wall or the door opening rather than a form edge, and every mat after registers to it. Get that wrong and there is no correcting it, a half stone against the wall is there for the life of the slab.

This is C-8 concrete work, with liability insurance on every job behind it. A finish changes nothing structural, so the slab beneath it is filed on the rules it would face plain. The 28 days a colored slab waits before its first sealer coat is the Portland Cement Association figure, not a habit of ours, and the release is off it long before then. Nothing closes until you have walked it, and a written workmanship guarantee against defects in how it was built goes with it.

When a stamped surface is done

Four Signs a Fullerton Stamped Slab Needs More Than a Coat

Slick before it looks worn

From May the marine layer leaves a film on hard surfaces into late morning, and a stamped face holds it in the shallow part of every stone. Where the walked line has lost the grit out of its top coat, the slab turns slippery months before it looks tired. That is the sealer going.

A repair you see from the door

Look for squares that catch the light differently, usually at a step or where a post came out. Broom concrete absorbs a patch in a season. A pattern does not, so every repair a stamped area has had stays legible from the front step, and past three or four the surface is done.

A step through the pattern

Under most of this city the top foot is sand over a horizon near 40 percent clay, and a panel that lifts on it steps at the joint. On a broom slab that is a line. On a stamped one the stones carry across the cut, so a quarter inch of movement breaks the pattern as well as the level.

Water sitting in the joints

A stamped surface drains off the tops of the stones and along the grout lines, so it wants the same quarter inch of fall per foot a plain slab does. Water standing in those lines a day after rain says the fall has gone, and water held in a pattern lifts a sealer from below.

On every stamped pour

Eight Things in the Figure on a Fullerton Stamped Pour

Eight things on every stamped pour, in the figure from the start. Most are here because everything decorative about this job is spent inside the hour concrete stays open, and none of it gets a second attempt.

The datum struck first

One chalk line goes down before any form does, struck square to the building, and every mat on the job is registered to that line.

Mats walked out dry

The set is laid over the forms with no concrete in them, so you see where the cut pieces fall before anything is ordered.

Rock under the whole area

Angular base is plated in layers to the depth a plain pour gets, because a pattern conceals nothing that moves beneath it.

Color dosed at the plant

Pigment goes into the load on the batch ticket rather than being shoveled in on site, and the reference is written on your sheet.

Release down, then off

Powder release goes on ahead of the mats so they lift clean, leaves the second color down in the joints, and comes off with a wash the next day.

Saw cuts in the grout

Joints are cut the same day and run down a grout line wherever the grid allows, so the blade reads as part of the pattern.

Grit in the top coat

A non-slip additive is stirred through the second sealer coat on anything walked in the morning damp, not only round a pool.

The reseal month written

You are handed the sealer used and the month the next coat falls due, since that coat is the only part of this slab you maintain.

The choice people actually make

Stamped, Brushed or Pavers on a Fullerton Lot

Almost nobody is choosing between two stamp patterns at this stage. They are choosing between a pattern pressed into concrete, the plain slab most of this city already has, and units laid loose on sand. The ground and the base are identical under all four.

OptionHow the face is madeWet underfootA repair laterUpkeep
Stamped concretePressed in while the top is softSlick unless grit is in the sealerShows however carefully it is doneSealer every 2 to 3 years
Broom-finish slabDragged across the wet surfaceGrips with the morning film on itA patch reads as a paler panelSealer every 4 to 5 years
Interlocking paversUnits bedded on sand over baseGrips, and the joints drainLift the units and relay themRe-sand the joints once a year
Stamped overlayA bonded skin over sound concreteThe same as a stamped pourDebonds in sheets, not in patchesSealer every 2 years, no vehicles

Only the pavers can be taken up and put back. The other three are settled in the hour concrete stays open, which is why the layout is drawn before a truck is booked.

Stamped front path and entry at a 1960s Fullerton tract house

Tract frontages and a late morning

Why a Stamped Pour in Fullerton Is Timed Rather Than Rushed

Two things set this work apart here, and heat is not one of them: what a pattern is doing on a postwar tract frontage, and how late a damp morning leaves the surface ready to take a print.

Of the 52,300 homes here, only about 1,500 predate 1940 and 33,200 date from the thirty years after 1950. A pattern at the front of one of those is almost never a match for something original: it is a deliberate change to a street of plain gray flatwork, and it wants deciding at the curb with the neighbors in view. Two corners of the city ask before that, because a Residential Preservation Zone address and a downtown one both go past Planning first.

Then there is the morning. Mean daily highs at the municipal airport station run 84.4 in July and 86.7 in August, a good ten degrees under the towns an hour inland, so none of this is a race against heat. The limit runs the other way: from May the marine layer holds bleed water on the surface into late morning, and a mat pressed into a slab still giving water up leaves a shallow, mottled print. So the sheen is watched and the mats follow it off.

How a stamped job runs

A Fullerton Stamped Pour, Stage by Stage

Five stages. Everything that fixes the look of this slab is settled in the first two, before a truck is booked, and the man who struck the datum has a mat in his hands on the day, that part of the job does not get handed over.

1

Measured, mats on the ground

Grant Yoshida tapes the area, opens a hole down to the clay, and puts the sample mats and chips out on the ground in daylight.

2

Pattern, color and datum

You pick the pattern and how the color goes in, the datum line is agreed on the plan, and none of the three is left to the day of the pour.

3

The counter, then the dig

The address goes up to the second-floor counter on Commonwealth, the old surface leaves the lot, and rock goes down in compacted layers behind it.

4

Poured, released, stamped

The color arrives in the load, the slab is placed and floated, and the mats follow the sheen off the surface rather than a clock.

5

Cut, washed, cured, sealed

Joints are sawn that afternoon, the release washed off a day later, then the slab cures 28 days before the first two coats go on.

Where the number comes from

Why Two Fullerton Stamped Areas the Same Size Differ

Area sets the floor and the hand work sets the rest. Two areas of the same size can be a day apart on nothing but how much of the surface gets touched again after the mats come off. Every estimate is measured and written on site.

How many stones are whole

A rectangle takes full mat runs. Every curve, bed and step means cutting the pattern in and retooling each joint by hand.

How the color goes in

Pigment in the load is one line on a batch ticket. A dry hardener is broadcast and floated in, which is a second pass over the whole area.

Whether it is one pour

An area a barrow run cannot cover before the top firms takes a pump and more hands, so the whole of it still goes down as one.

What the pattern meets

A border at a bed, a riser or a coping is a second layout and a second set of edges, tooled foot by foot after the mats lift.

No stamp is worked off a photograph, so the mats and chips come to you. Ring the Harbor Boulevard yard, or fill the form in and a time is fixed within 1 business day. (657) 500-3759 or send us a message.

Want a stamped slab measured in Fullerton?

Send the form or ring the yard on Harbor Boulevard. The mats and the color chips come out to the property and get judged in your own daylight, from the distance the slab is actually looked at, and the figure is written before we leave.

Request a Free Estimate

Written on site · No obligation

By submitting, you agree to our disclosure and consent terms, including being contacted by Harbor Fullerton Concrete.

Stamped jobs in this city

Three Fullerton Stamped Slabs, in the Owners' Words

Three reviews from Google, Facebook and the BBB. One entry and path on a 1960s frontage, one back garden poured on a gray June morning, and one older slab that turned out to be a candidate for an overlay.

Google review

“Ours is a 1963 tract house and every frontage on the street is plain gray. He chalked a line off the porch and walked the mats out dry so I could see where the cut pieces would land. Not one half stone against the wall, and the saw cuts are down the joints.”

Priscilla T. of FullertonStamped entry and path · Google · 2026
Facebook review

“They turned up early in June and then sat and waited nearly two hours for the wet to come off the top before touching it. I thought we were losing the day. The print is deep the whole way across 380 square feet and there is no join anywhere in it.”

Nolan K. of Sunny HillsStamped rear patio · Facebook · 2026
BBB review

“We had been quoted to break out a sound slab. Grant drilled it, said it was flat and had nothing live in it, and stamped an overlay on top instead. He was straight that it would not take the caravan, so that end stayed as it was. Sealed and dated on the sheet.”

Bettina S. of Raymond HillsStamped overlay on a patio · BBB · 2025

FAQ

Stamped Concrete Questions Fullerton Owners Ask

What gets settled before a pattern is picked: what is filed and where, what can still be altered afterward, where the color ought to sit, what actually needs maintaining, and why a gray morning changes the start time.

(657) 500-3759
  • Is a stamped slab filed differently in Fullerton?

    No. A stamp adds nothing structural, so the slab is filed as any other in that spot would be. The Residential Code exempts a driveway or a sidewalk not more than 30 inches above adjacent grade, and puts retaining walls in a separate clause at 4 feet from the bottom of the footing to the top. Patios appear in neither. Fullerton publishes no exemption list, so the address goes to the counter as a question.

  • What can still be altered once the mats come off?

    The tone, slightly, and nothing else. The impression is a quarter of an inch into concrete that has set, and the pigment is either through the load or floated into the face, so both are permanent within hours of placement. A tinted sealer shifts the shade a shade and wears off with the coat. Anything more than that means breaking the slab out, which is the reason so much of this job happens on paper.

  • Integral color or a cast-on hardener on a slab here?

    Integral where anything drives or parks, a hardener where it does not. Pigment dosed at the plant runs through all 4 inches, so a corner knocked off years later is the same color right the way in. A dry hardener works into the top eighth of an inch and leaves a harder, deeper-toned face, worth having on a path or under a cover. Neither one is a coating, and that is the whole difference from paint.

  • What actually needs maintaining on a stamped slab?

    The sealer, and only the sealer. It carries the sheen, holds the release tone in the grout lines and takes the ultraviolet, so it is the sacrificial part of the job rather than the color beneath it. Outdoors here that is two coats every 2 to 3 years, and nearer 2 on a frontage cars stand on. Wash it and recoat on that cycle and the surface holds; leave it and the walked line goes first.

  • Does a stamped surface get slippery on a damp morning?

    It can, and here that matters more than it does round a pool. The marine layer sits over this city into late morning from May onward, and a gloss coat on the smooth part of a stone is genuinely slick with that damp on it. So a grit additive goes into the second coat on anything walked before noon, and a mat with a coarser face is picked for a path rather than a border.

  • Can stamped concrete be repaired without the patch showing?

    Rarely, and it is worth knowing that before you choose it. A repair to a broom slab is a paler panel that weathers in. A repair to stamped work has to reproduce a stone shape, a grout line and a color that was mixed and dosed years earlier, and the new concrete cures at a different rate on top of it. Where a whole panel has moved, the honest answer is often a border and a fresh area rather than a patch.

  • Why does the whole area have to be poured in one go?

    Because color is dosed by the yard and two loads batched an hour apart can land a shade apart. That difference hides under a fresh sealer and appears as the coat thins, along a straight line rather than as a gradient, and no recoat takes it out. The same goes for the mats: once the first stretch has firmed, a set pressed into it later leaves a seam. So the hands are booked against the square footage.

  • What time of day do you press the mats in Fullerton?

    Behind the sheen, whenever that turns out to be. An inland crew books a summer pour for first light and races the heat; copying that here is the wrong instinct, because what stands between the truck and the first mat in this county is damp air. So the forms are set and the load placed early, and then everyone waits. A gray June start can push that wait two hours past an October one.
